WrapPro crew installing a basement waterproofing membrane against an excavation wall

Basement waterproofing

Below ground, you get one attempt at getting it right.

Once the raft is cast and the walls are backfilled, the outside of your structure is gone forever. Every later fix is an internal compromise on a building that is already occupied.

What clients tell us first

The concerns behind the enquiry.

  • “If it leaks later, can it even be repaired?”

    Honestly, not the way it was built. Once earth is against the wall, remediation happens from the inside — grouting, cavity drainage, managing water rather than excluding it. That is why we would rather spend time with you at the design stage than at the excavation stage.

  • “Our site has water sitting at almost slab level.”

    Then hydrostatic pressure, not rainfall, is the design condition — and that changes the system, the sequence and the dewatering plan. We would rather tell you that early than discover it in the middle of a pour.

  • “The membrane gets destroyed before the concrete is even poured.”

    A fair concern, and a common failure. Reinforcement, chairs, pumps and boots all cross the membrane before it is protected. We plan the sequence with your site team and inspect immediately before the pour, when it can still be fixed for the cost of a patch.

Where it really goes wrong

What actually causes the failure.

01

Water tracking behind the membrane

When a membrane is not fully bonded, water that finds one breach can travel metres before it appears inside — which is why below-ground leaks are so hard to trace and so often 'repaired' in the wrong place.

02

Construction joints and kickers

The junction between raft and wall is where most basements let water in. It needs a continuous, designed treatment, not two systems meeting hopefully.

03

Penetrations and pits

Service entries, tie-rod holes, lift pits and sumps are the lowest, wettest points on the site and get the least attention on the drawings.

04

Damage before the pour

Puncture damage during steel fixing is normal. Leaving it undetected is not.

WrapPro crew laying and welding pre-applied HDPE membrane across a basement raft

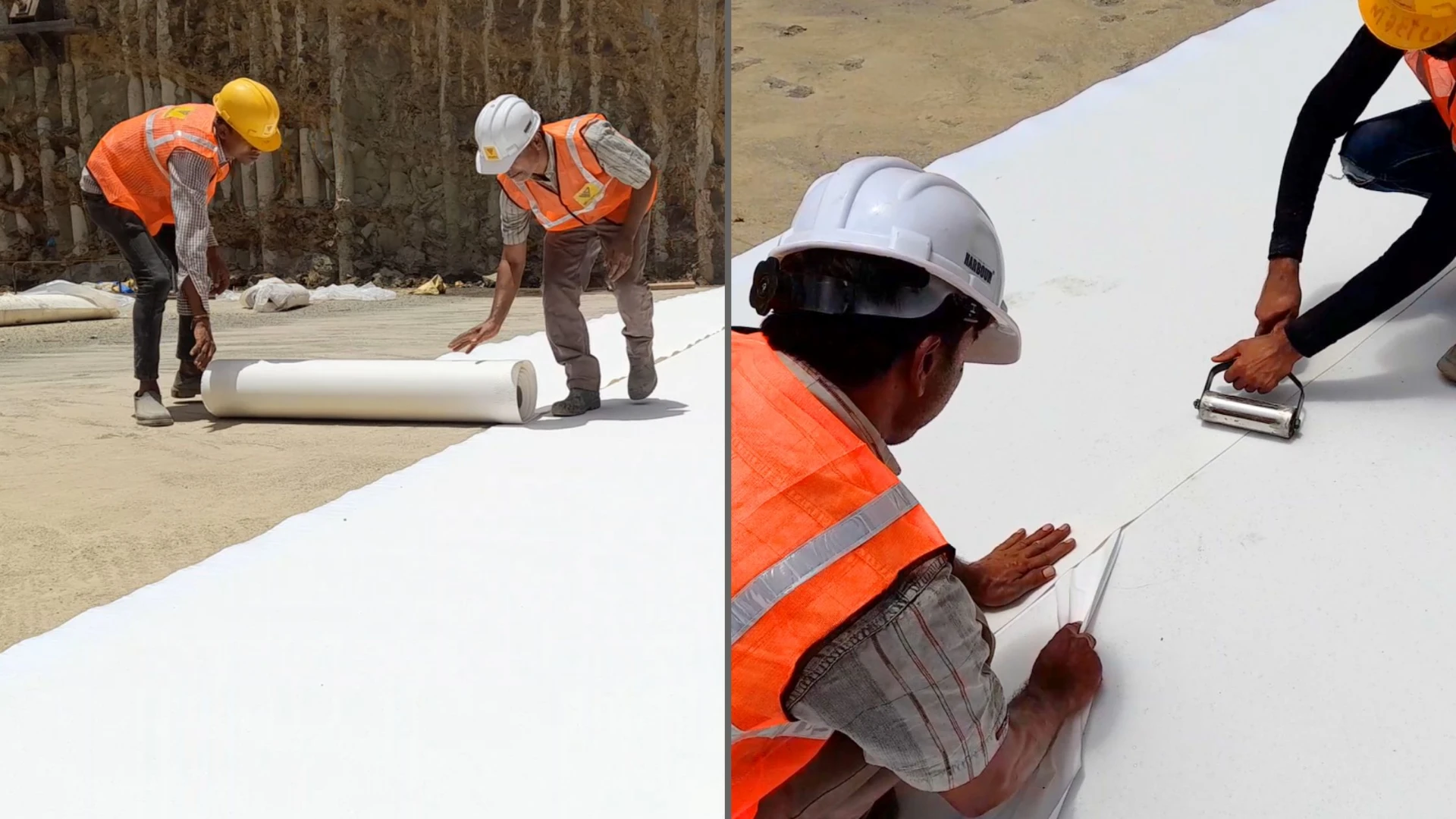

Pre-applied HDPE is laid, lapped and welded before the raft is cast — every seam pressure-rolled, so water cannot migrate. Once earth is backfilled, this surface is gone forever.

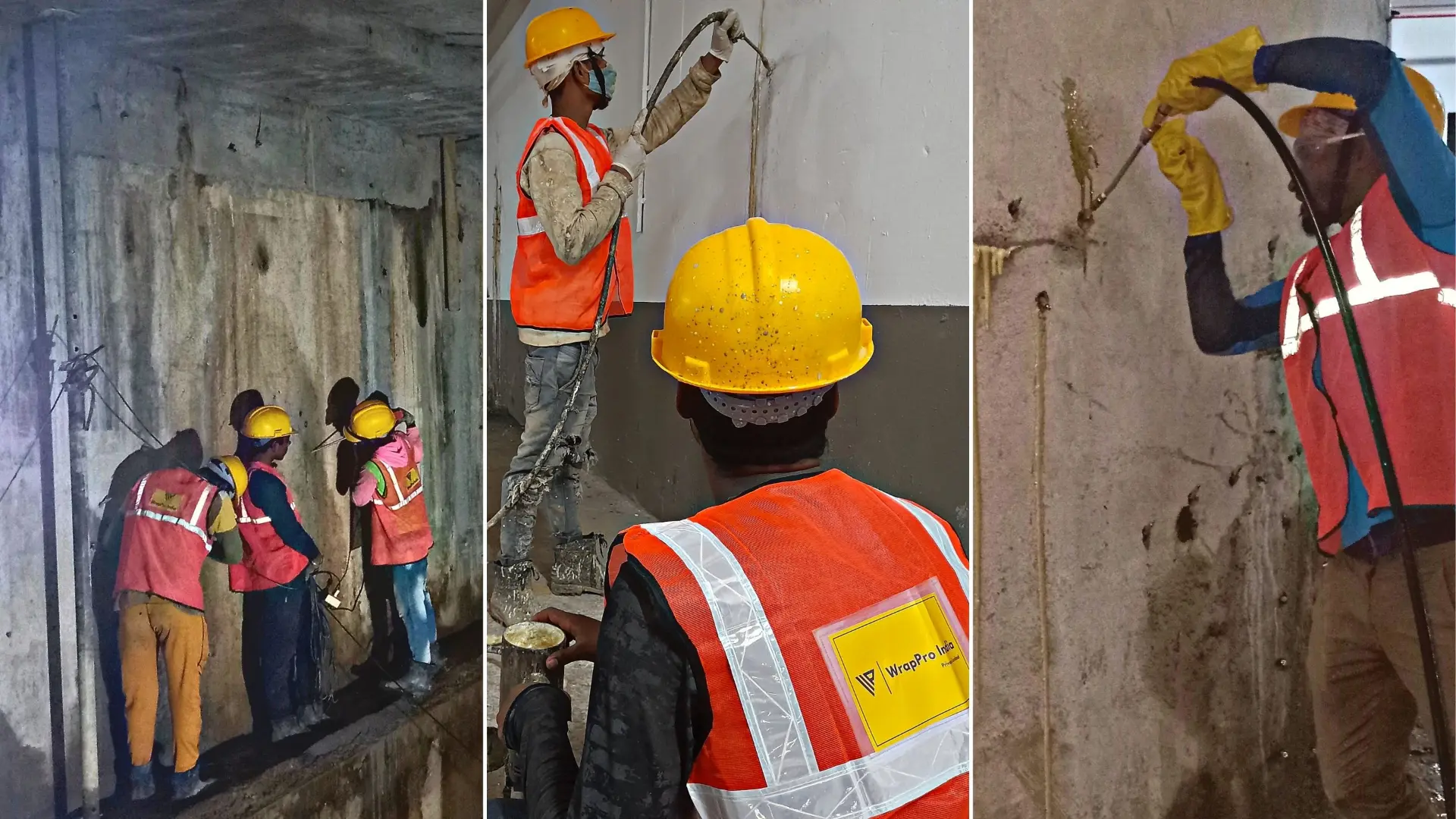

WrapPro crew tracing and treating active leakage on a basement retaining wall with PU grout injection
On existing basements, live ingress is traced to its source and stopped with PU grout injection — remediation done properly, never a substitute for a designed system.

How we approach it

What we do differently, and why it matters to you.

  • We read the site before the system

    Water table, soil, dewatering plan, structural sequence and future access decide whether pre-applied bonded membrane, crystalline concrete protection, drainage-based management or a combination is correct.

  • Fully bonded wherever access is lost

    Pre-applied weldable HDPE bonds to the concrete as it cures, so water cannot migrate between membrane and structure. Where a breach occurs, it stays where it happened.

  • Sequenced with your structural programme

    Membrane work below ground lives or dies by coordination with steel fixing, formwork and pouring. We agree the sequence in writing with your site team and hold pre-pour inspections.

  • Injection grouting as remediation, not as a plan

    We do carry out grouting on live ingress, and we do it well. But we will always tell you plainly when grouting is treating a symptom of a design decision.

Scope & systems

What this scope covers.

Below ground you get one attempt. Once the raft is cast and the retaining walls are backfilled, remediation costs many times what the original system did — and disrupts a building that is already in use.

Systems we use

  • Pre-applied weldable HDPE membranes
  • Crystalline and cementitious systems
  • Injection grouting for active water ingress
  • Cavity drainage and drainage board systems

Typically specified for

  • Raft slabs and retaining walls
  • Basement car parks and services levels
  • Lift pits, sumps and tank rooms
  • High water-table sites

What you get

What actually reaches you at the end of it.

  • A below-ground strategy tied to the actual water table and sequence
  • Pre-pour inspection records at every critical stage
  • Continuous detailing at raft-to-wall junctions and penetrations
  • Documented method statements your consultant can review
  • Clear, honest advice when a cheaper approach will cost you later
  • A team still contactable when the basement is in service

Questions

What clients ask us about this scope.

The right system depends on groundwater conditions, depth of excavation, soil conditions, structural design, access around the structure, construction sequence, retaining wall methodology and the expected level of water pressure.

Basement waterproofing should therefore be selected as part of the overall substructure design rather than as a standard product applied to every project.

For critical structures, the most important question is not simply which membrane is being used, but whether the complete waterproofing strategy addresses joints, penetrations, terminations and other vulnerable interfaces.

The key is to treat basement waterproofing as a complete system rather than only as membrane installation.

The project should address substrate preparation, continuity of the waterproofing layer, construction joints, penetrations, raft-to-wall junctions, terminations, protection against damage and inspection before the waterproofing becomes inaccessible.

Backfilling should take place only after the relevant waterproofing areas have been inspected, accepted and adequately protected.

Leakage frequently occurs at interfaces and discontinuities rather than through the main membrane area.

Typical vulnerable locations include construction joints, raft-to-wall junctions, pile interfaces, pipe penetrations, tie-rod locations, expansion joints, kicker joints and membrane terminations.

These details should be resolved before execution and inspected carefully because even a high-performance membrane can fail if continuity is lost at a critical junction.

This is a major part of successful substructure waterproofing.

Membranes can be damaged by reinforcement work, shuttering, movement of labour and equipment, subsequent trades or backfilling activities.

The waterproofing methodology should therefore include inspection, protection and controlled handover between trades before the membrane becomes concealed.

A waterproofing system that is correctly installed but subsequently damaged can still result in leakage.

Before closure, the project team should verify that the waterproofing is continuous, critical details have been completed correctly, penetrations and joints are properly treated, visible damage has been rectified and the membrane is adequately protected.

Inspection records, approved details, QA/QC documentation and closure of identified snags become especially important because the system may never be accessible again.

For basement waterproofing, the final inspection before concealment is one of the most important stages of the entire process.

Next step

Tell us what is worrying you about this scope.

Send us the drawings or the specification you have been handed. We will tell you where we agree, where we would do it differently, and exactly what a lower quotation has left out.
